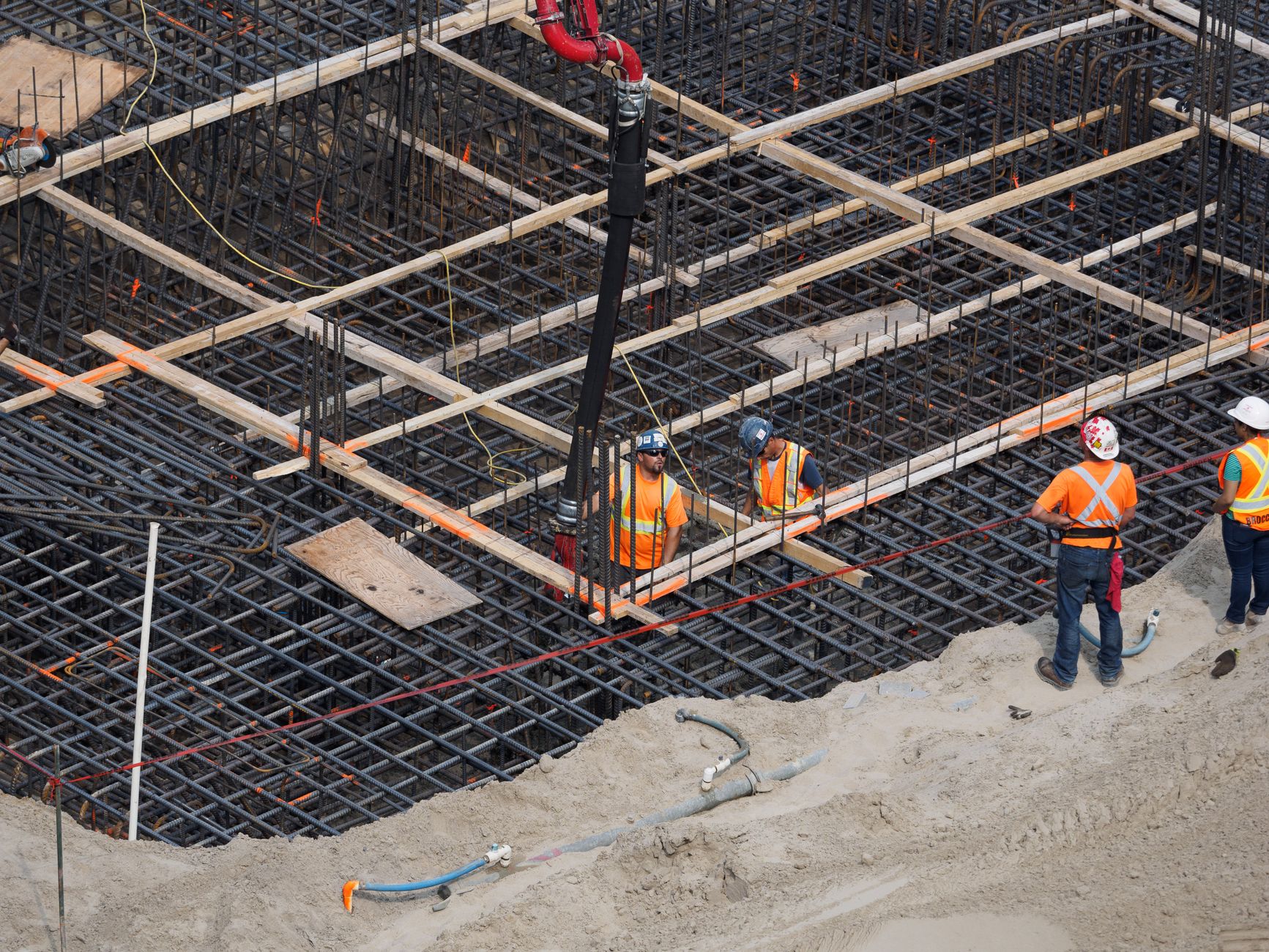

Pouring Concrete in Spring — Temperature, Mix, and Timing Matter
Here's the thing about pouring concrete in spring. Mother Nature doesn't care about your schedule. She'll give you a beautiful 62-degree morning and then drop to 34 degrees overnight. She'll hold off the rain until your finishers are halfway through a 3,000 square-foot slab and then dump an inch in 20 minutes.
I've poured concrete in every month of the year across 28 years in this business. And spring is the sneakiest season of all. Summer is hot but predictable. Winter is cold but you plan for it. Spring? Spring will fool you. You think you've got a perfect pour day lined up and then the weather does something you didn't expect.
I've seen more scrapped pours, more cracked slabs, and more surface defects in April and May than any other months. Not because spring concrete is impossible — it's because guys don't respect the variables.
Let's talk about how to get it right.
The Temperature Window You Need to Hit
Concrete has a sweet spot: 50°F to 77°F ambient temperature during placement and for 48 hours afterward. That's not a suggestion. That's what ACI 306 (cold weather) and ACI 305 (hot weather) are built around.
In spring, you're usually worried about the cold side. Morning temperatures in the 30s and 40s are common across most of the country in March and April. And here's what a lot of crews miss — it's not just the air temperature at pour time that matters. It's the temperature of the subgrade, the forms, the reinforcement, and the concrete itself.
If your subgrade is 38°F and your concrete hits it at 65°F, the bottom of your slab is going to set at a completely different rate than the top. That differential curing causes curling — the edges of the slab lift up because the top shrinks faster than the bottom. I've seen slabs curl a quarter-inch in 24 hours. That's a trip hazard and a floor covering nightmare.
Pro tip: Check your subgrade temperature with an infrared thermometer gun the morning of the pour. If it's below 40°F, delay the pour or use insulating blankets on the subgrade overnight. A $200 set of concrete curing blankets can save you from a $20,000 tear-out and re-pour.
Getting the Mix Right
Your ready-mix supplier is your most important partner on a spring pour. And you need to communicate with them, not just fax over a yardage number.
For spring pours when overnight lows might dip into the 30s, I specify these modifications:
Higher cement content. Going from a standard 5-sack mix to a 6-sack mix increases the heat of hydration — the chemical reaction that makes concrete set generates its own heat. More cement means more heat, which helps the concrete cure even when ambient temps drop.
Type III Portland Cement. Type III is a high-early-strength cement that reaches design strength faster than standard Type I. It generates more heat in the first 24 hours and gets you to a strength level where freeze damage is unlikely within the first day. The upcharge is usually $8-12 per yard. Worth every penny in marginal weather.
Accelerating admixtures. Non-chloride accelerators like Fritz-Pak NCA or Master Builders MasterSet AC 534 speed up set time without the corrosion risk that calcium chloride brings. I use these on every spring pour when the forecast shows overnight lows below 40°F.
Lower water-cement ratio. This is fundamental. The less water in the mix, the faster it sets and the stronger the final product. I target a 0.45 w/c ratio for spring slabs. Tell your dispatcher — they should know exactly what that means.
Pro tip: Never add water to the truck on site to improve workability. Every gallon of water you add reduces the 28-day compressive strength by approximately 200 PSI. If the mud is too stiff to work, use a mid-range water reducer admixture instead. Same workability, no strength loss.
Timing Your Pour — The Spring Playbook
In summer, you pour early to beat the heat. In winter, you pour mid-day to catch the warmth. Spring? You need to thread the needle.
My spring pour schedule looks like this:
For slabs-on-grade:
- Check the 72-hour forecast three days before the pour. If any overnight low in the next three nights is below 32°F, reschedule or plan for heated enclosures.
- Pour starts between 8:00 and 10:00 AM. This gives the concrete the full warmth of the afternoon to begin setting before temperatures drop at night.
- Finishing should be complete by 3:00 PM at the latest. You need time to get your curing compound on and your blankets down before the afternoon cooling begins.
For foundation walls:
- More forgiving because the forms insulate the concrete. But strip too early in cold weather and you'll get thermal shock — the surface cools rapidly and crazes.
- I leave forms on for a minimum of 48 hours in spring. 72 hours if overnight lows are in the 30s.
- Strip in the morning so the exposed concrete has the full day to equilibrate with ambient temperature.
For footings:
- Footings in contact with frozen or near-frozen soil are a disaster waiting to happen. The soil can freeze-heave after the pour, lifting your footing out of level.
- If your soil temperature is below 35°F at footing depth, you need to thaw it first. Hydronic ground thaw systems work but are expensive. The budget option is insulating blankets laid on the ground for 48-72 hours before excavation.
The housing starts numbers for Q1 2026 mean a lot of foundations are going in right now. A lot of those pours are happening in marginal weather because the schedule pressure is intense. Don't let schedule pressure override concrete science.
Pro tip: Build a relationship with one or two dispatchers at your ready-mix plant. They know which trucks run hot, which drivers are reliable, and they can squeeze you in for an 8 AM delivery when the schedule is tight. Bring them a case of beer at Christmas. Seriously.
Curing Is Where Spring Pours Live or Die
You can have the perfect mix, perfect temperature, perfect timing — and still ruin the pour with bad curing. This is where I see the most mistakes in spring.
Concrete needs to maintain moisture and temperature for a minimum of 7 days to achieve proper strength development. In lab conditions, concrete reaches about 70% of its 28-day strength at 7 days. But that assumes 73°F and 100% humidity. In a spring environment with fluctuating temperatures and wind? You need to actively manage curing.
Curing compounds: I use a white-pigmented curing compound (ASTM C309 Type 2) on every exterior slab. The white pigment reflects sunlight and keeps the surface cooler during the day, while the membrane retains moisture. Apply it immediately after final finish — don't wait. If the surface starts to look dry before you get the compound on, you're already losing moisture.
Curing blankets: For overnight protection when temps will drop below 40°F, insulated curing blankets are essential. The concrete blankets with the foam core and poly shell are the ones you want — not just tarps. Tarps trap moisture but don't insulate. You need both.
Wet curing: On high-value flatwork where surface durability matters — garage floors, warehouse slabs — wet curing with burlap and soaker hoses for 7 days produces the best results. It's labor-intensive but the surface hardness and abrasion resistance are noticeably better.
What NOT to do: Do not use polyethylene sheeting directly on fresh concrete in cold weather. It traps moisture and creates a greenhouse effect during the day, then lets the surface cool rapidly at night. The result is ugly blotchy discoloration and potential plastic shrinkage cracking.
Pro tip: Buy a set of digital temperature loggers — Lascar EL-USB-1 or similar — for about $25 each. Embed them in the concrete and under the blankets. Download the data after 7 days. Now you have a documented curing temperature record that proves your concrete was properly protected. Inspectors love this. Lawyers love this more.
The Spring Rain Problem
Rain is the enemy of fresh concrete. Water hitting an unfinished surface dilutes the paste, reduces surface strength, creates scaling, and leaves pockmarks.
You cannot control the weather. But you can be prepared for it.
Every spring pour, I have the following on site:
Enough poly sheeting to cover the entire pour area. Not a tarp — 6-mil polyethylene in rolls. It's cheap, it's light, and two guys can unroll it across a slab in under a minute.
Pop-up canopy frames. I keep four 10x10 pop-up canopy frames (no fabric tops) on my trailer. We stretch the poly over the frames to create a rain shelter above the finishing crew. This lets them keep working in light rain without water hitting the surface.
A weather app with radar. Not the default iPhone weather app — something with radar overlay and hourly precipitation probability. I use RadarScope. If I see a cell moving toward the site, we shift into covering mode 15 minutes before it arrives.
A plan to stop. Sometimes the right call is to stop pouring. If a major storm is moving in and you've only placed half the slab, you need a cold joint plan. Where will the joint go? Is it at a logical break point? Can you bull-float what you've placed and cover it? Having this conversation before the first truck arrives saves chaos later.
Pro tip: If rain does hit your fresh concrete surface, do NOT try to finish through it. Do NOT sprinkle dry cement on the surface to absorb water — that's an old-school myth that creates a weak, powdery surface layer. Cover the concrete, wait for the rain to stop, then carefully remove standing water with a rubber squeegee before resuming finishing. If the surface has been severely washed out, you may need to re-float.
Hot-Cold Swings: Spring's Sneakiest Problem
A 65-degree afternoon followed by a 35-degree night creates a 30-degree temperature swing. That's brutal on fresh concrete.
The surface cools faster than the core. The surface contracts. The core doesn't. Result: surface cracking. These aren't structural cracks — they're thermal cracking caused by differential cooling. But they're ugly, they collect dirt, and if they're on a slab that'll be stained or polished, the job is ruined.
My protocol for days with wide temperature swings:
Delay the pour until the swing narrows. If Thursday's forecast shows a 30-degree day-night spread but Friday shows only 15 degrees? Pour Friday.
Insulate early. Get blankets on while the concrete is still warm from hydration heat. Don't wait until the temperature has already dropped. By then, the damage is happening.
Use fibers. Synthetic micro-fibers (like Fibermesh) at 1-1.5 lbs per cubic yard significantly reduce plastic shrinkage cracking and thermal cracking. They're not structural. They're insurance. Adding them to the mix costs about $3-5 per yard. Cheap insurance when lumber and materials are already eating your margins.
Cut control joints early. I soft-cut joints with an early-entry saw (Soff-Cut) within 4-6 hours of finishing. Don't wait until the next morning. In spring conditions with temperature swings, random cracking can start within 8-12 hours. If your control joints aren't in before the cracking starts, they're useless.
Pro tip: Control joint spacing for 4-inch residential slabs should be no more than 8-10 feet in both directions. The old rule of "2-3 times the slab thickness in feet" works well — so a 4-inch slab gets joints every 8-12 feet. In spring, I lean toward the tighter spacing.
Subgrade Prep in Wet Conditions
Spring soil is wet. Frost is coming out. Water tables are high. And you're trying to place a perfectly flat slab on ground that wants to be a swamp.
Subgrade preparation in spring requires more attention than any other season. Here's my checklist:
Proof-roll with a loaded dump truck. Drive a loaded tandem axle across the subgrade. Any area that pumps (bounces or deflects visibly) needs to be excavated and replaced with granular fill. Don't pour on pumping subgrade — the slab will crack and settle.
Compact in lifts. If you're adding granular base, compact it in 4-inch lifts with a vibratory plate compactor. Get a density test if the project size warrants it. Anything over 2,000 square feet, I'm pulling a nuclear density gauge test.
Grade to drain. Even under an interior slab, grade the subbase so water migrates away from the center. A 6-mil poly vapor barrier goes down over the graded subbase. Lap the seams 12 inches and tape them. Water under a slab causes all kinds of problems — moisture-related floor covering failures, mold, heaving.
Don't pour on mud. This sounds obvious but I see it every spring. If your subgrade is saturated, let it dry or excavate it and replace it. Pouring concrete on saturated soil doesn't work. The bleed water has nowhere to go, set times become unpredictable, and the slab-soil contact is compromised.
Testing: Don't Skip It
Spring pours need testing discipline. At minimum:
Slump test every truck. Your target slump is on the mix design — usually 4-5 inches for slabs. A truck that shows up at 7-inch slump has too much water. Reject it or have the driver add cement (if the plant can authorize it).
Air content on every load if you're using air-entrained concrete (which you should be for any exterior flatwork in freeze-thaw climates). Target is usually 5-7%.
Temperature of the concrete at delivery. Should be between 50°F and 77°F. Concrete that arrives below 50°F is going to set slowly and be vulnerable to freeze damage. Concrete above 77°F sets too fast and is hard to finish.
Cylinder specimens for strength testing. A standard test set is four cylinders — one tested at 7 days and two at 28 days, with one held in reserve. Spring pours with marginal conditions should get extra sets.
Pro tip: Build the testing cost into your bid. Third-party testing on a residential foundation and slab runs $300-500. That's nothing compared to the liability exposure of an untested pour that fails.
The Bottom Line
Spring concrete is not summer concrete with a jacket on. It's a completely different animal that requires different planning, different materials, and different protection.
Respect the temperature. Communicate with your ready-mix plant. Time your pours for maximum warmth. Cure aggressively. Prepare for rain. And test everything.
The builders who pour great concrete in spring are the ones who plan for the worst and manage every variable they can control. The builders who wing it are the ones tearing out and re-pouring in June.
Don't be that guy.
Frequently Asked Questions
At what temperature should I cancel a concrete pour?
ACI 306 considers any time the ambient temperature is below 40°F to be cold weather concreting, which requires special precautions. I won't pour if the ambient temperature at placement time is below 35°F unless I have heated enclosures and hot water in the mix. More importantly, if the forecast shows overnight lows below 25°F within the first 48 hours after placement, cancel or postpone. Fresh concrete that freezes before reaching 500 PSI compressive strength is permanently damaged — the ice crystals disrupt the cement matrix and the concrete will never reach design strength.
How long should I leave forms on a spring foundation pour?
Minimum 48 hours in spring conditions, and I prefer 72 hours when overnight temperatures drop below 40°F. The forms act as insulation that protects the concrete from rapid temperature changes. Stripping too early exposes the concrete to thermal shock — the surface temperature drops rapidly, causing surface cracking and crazing. When you do strip, do it in the morning so the exposed concrete has the warmest part of the day to gradually equilibrate with ambient conditions. If you must strip earlier for schedule reasons, cover the exposed surfaces with insulating blankets immediately.
Should I use calcium chloride accelerator in spring concrete?
I avoid calcium chloride in almost all situations. Yes, it's cheap and effective as an accelerator. But it significantly increases the risk of corrosion on any embedded reinforcement — rebar, wire mesh, post-tension cables. In a garage slab with welded wire mesh, calcium chloride can initiate corrosion within a few years, leading to rust staining, spalling, and structural degradation. Use non-chloride accelerators instead. They cost more per yard but eliminate the corrosion risk entirely. The only scenario where I might use calcium chloride is in a plain concrete footing with zero reinforcement, and even then, the non-chloride options are just better practice.
How do I handle a cold joint if I have to stop a spring pour mid-slab?
Cold joints happen when fresh concrete is placed against concrete that has already begun to set. In spring, slower set times can actually help you — you have a wider window before the first placement stiffens. If you must stop, do it at a planned control joint location if possible. Bull-float the placed concrete to final grade, insert a bulkhead or form board at the joint location, and cover the edge with wet burlap to prevent it from drying. When you resume, apply a bonding slurry (neat cement paste) to the hardened edge before placing the new concrete against it. Vibrate thoroughly at the joint to ensure consolidation. A properly executed cold joint should be nearly invisible and structurally sound.
